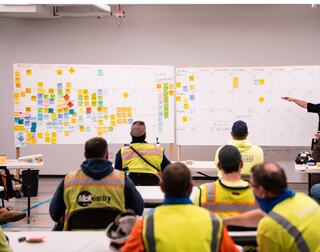

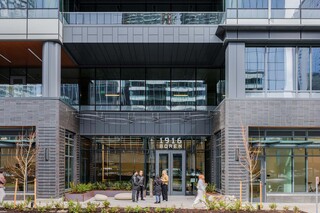

Starting interiors work sooner
At Trammell Crow Company's 1916 Boren, we used a new rebar coupler system to eliminate leave-out strips, allowing us to start interior buildouts more quickly. This marks the first time PS=Ø's system has been used in Washington state.
During concrete pours, large slabs are separated by unfilled strips to accommodate concrete shrinkage during curing. The strips are filled in later, requiring significant reshoring and for formwork to remain in place on the floor below. The new coupler system allows crews to pour two slabs without leaving a pour strip between them. Instead, the concrete's movement during curing creates a thin joint that can be grouted. The tubes inside the couplers are also grouted, locking the rebar into place.
CASE STUDY: PRESERVING HISTORY

At Seattle’s 400 Westlake, Lewis preserved the 1920s Firestone Building façade while constructing a new 16-story office tower inside it. The team installed custom-fit braces in place to support the façade during construction.
Learn moreSupporting the façade
Lewis crews needed to install a series of steel braces along each face of the façade, creating a supportive triangle between the upper façade, lower façade, and a temporary footing in the ground. These braces needed to be in place until the new structure could be permanently attached to the existing one. To the naked eye, each brace looked identical to the next.
Showing its age
Yet the century-old façade wasn’t perfectly flat or straight anymore, and unexpected obstructions within each wall made it near impossible to pinpoint the exact mounting point of each brace.
A perfect fit
Using a laser-generated point cloud scan and a detailed Revit model, our VDC and survey teams provided exact dimensions to the steel fabricator, eliminating weeks of field modifications. The braces arrived ready to install—no adjustments needed.
Achieving major schedule savings
The result? The beams arrived on a truck, were lifted into place and welded on, no modification necessary. Thanks to proper planning, the team saved over five weeks on the project.
